The quick decision path

Final calls belong to the mitigation contractor and adjuster, but these are the factors they weigh.

  • IfClean supply-line or sprinkler water, extracted quickly, tiles still flat and bondedThenDrying in place is often possible, followed by cleaning and a check that the adhesive held.
  • IfTiles are curling, the backing is delaminating, or the adhesive has let goThenReplacement is the usual outcome, even if the face looks fine.
  • IfWater came from a toilet overflow, drain backup or anything with sewageThenPorous flooring in the affected area is generally removed and the subfloor cleaned and treated.
  • IfWater sat for several days before anyone found itThenEven clean water can degrade; expect contamination concerns and likely removal.
  • IfOnly some tiles in a large area are affectedThenAsk about matching. Replacing a patch with a newer dye lot can leave a visible difference that becomes a separate dispute.

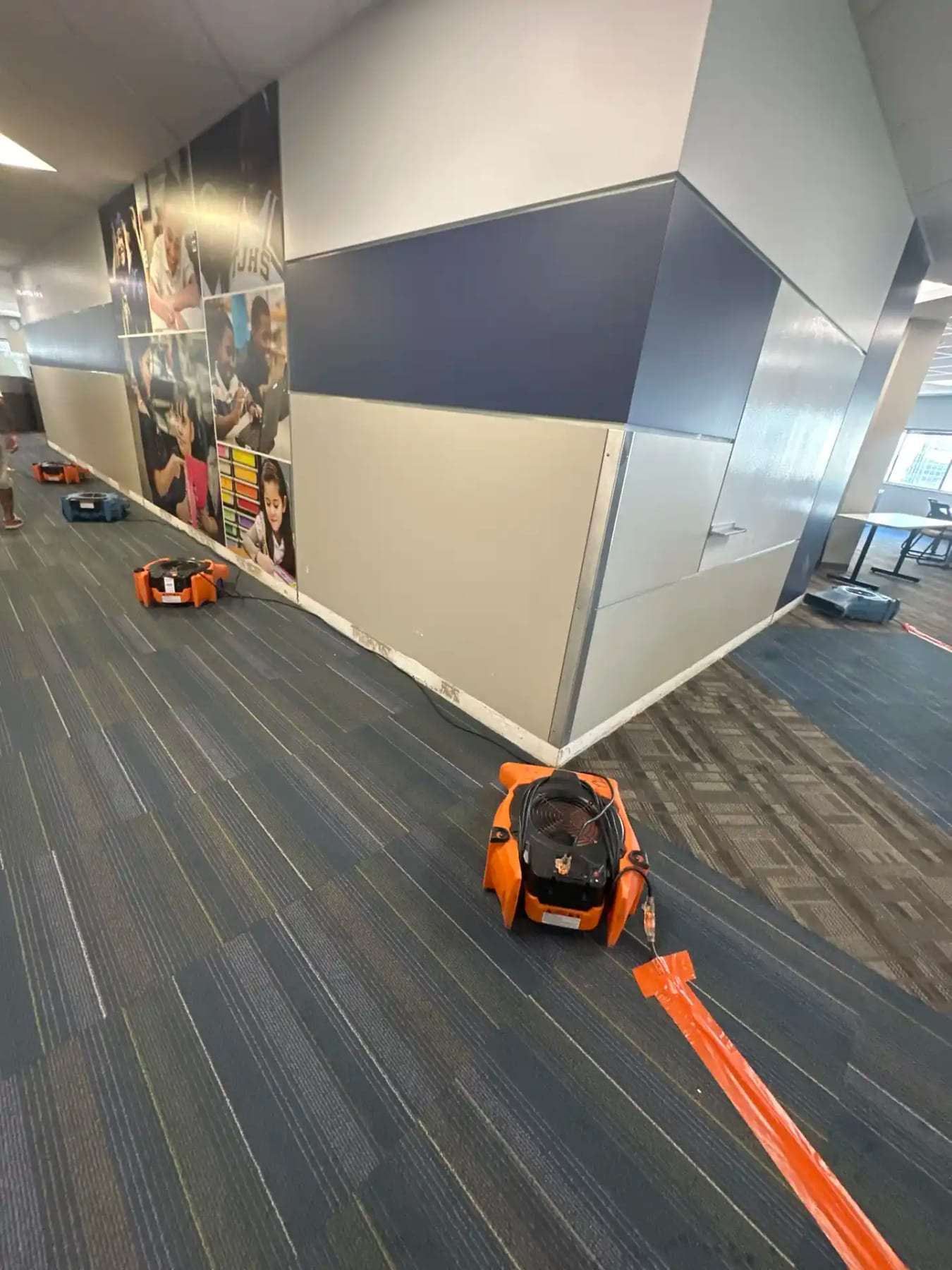

Air movers drying patterned carpet along an office corridor

Air movers drying patterned carpet along an office corridor. A general example of this kind of work, not a photo of a particular home, business or job.

Factors that change the outcome

Factor
Water source
Favors drying
Clean supply line
Favors replacement
Drain, sewer, or long-standing water
Factor
Time wet
Favors drying
Extracted within hours
Favors replacement
Wet for days
Factor
Backing
Favors drying
Stable, intact backing
Favors replacement
Delaminating or swelling backing
Factor
Install method
Favors drying
Releasable adhesive that re-tacks
Favors replacement
Adhesive that has emulsified or failed
Factor
Subfloor
Favors drying
Sealed concrete that dries readily
Favors replacement
Concrete with high moisture or old adhesives under the tile
Factor
Availability
Favors drying
Same style still in stock
Favors replacement
Discontinued pattern in a large field

Raised access floors are a special case

Some downtown offices, trading floors and data rooms use raised access floors, with panels set on pedestals and cabling or air distribution underneath. Water entering that space spreads widely and out of sight. The panels must be lifted to extract it, and the cavity treated like a ceiling plenum: dried, checked for wet cabling, and verified before panels go back.

If the underfloor space is used for air distribution, wet conditions there can move odor and moisture into the occupied space. Make sure the HVAC vendor is part of the plan.

Older floors may also hide older materials. Before cutting or grinding flooring in a pre-1980s building, ask whether the floor tile, mastic or leveling compound below has been tested for asbestos.

Before you approve drying in place

  • Confirm the water source and category in writing.
  • Ask for moisture readings in the concrete under the tile, not just the tile itself.
  • Pull a few tiles in the wettest area to check the adhesive and the slab.
  • Agree on how the floor will be verified dry and what happens if tiles later curl.
  • Keep a few spare tiles from attic stock, if any, for matching.

Common questions

Can carpet tile be pulled up, dried and reinstalled?

Sometimes, if the tiles are numbered and kept flat and clean while the slab dries. It works better with releasable adhesive and clean water.
